Best Transportation – Highway
Brazos County Highway 6, known locally as the “Big 6,” is a major improvement project along SH 6 focused on enhancing safety, relieving congestion, and improving mobility in the Bryan/College Station region.
TxDOT awarded a $671 million contract to Fluor Heavy Civil, LLC, representing a significant infrastructure investment as the area continues to grow.Fast Facts
Award Category: Best Transportation – Highway
Project: TxDOT – Brazos County Big 6 Improvement Project
Location: Hwy 6, College Station, TX 77842
Owner: Texas Department of Transportation (TxDOT) (Austin, TX)
General Contractor: Fluor Heavy Civil, LLC
Precast Manufacturer: Summit Precast Concrete (Montgomery, TX)
Project OverviewThe Big 6 project expands the corridor from four main lanes to six (three in each direction), reconfigures auxiliary lanes, and introduces collector-distributor lanes at key locations to support safer, more efficient merging. Interchanges are being upgraded to improve traffic flow, and new shared-use paths are being added to accommodate bicycles and pedestrians.
Construction began on December 1, 2025, following the project being let in March 2025.
Precast Scope

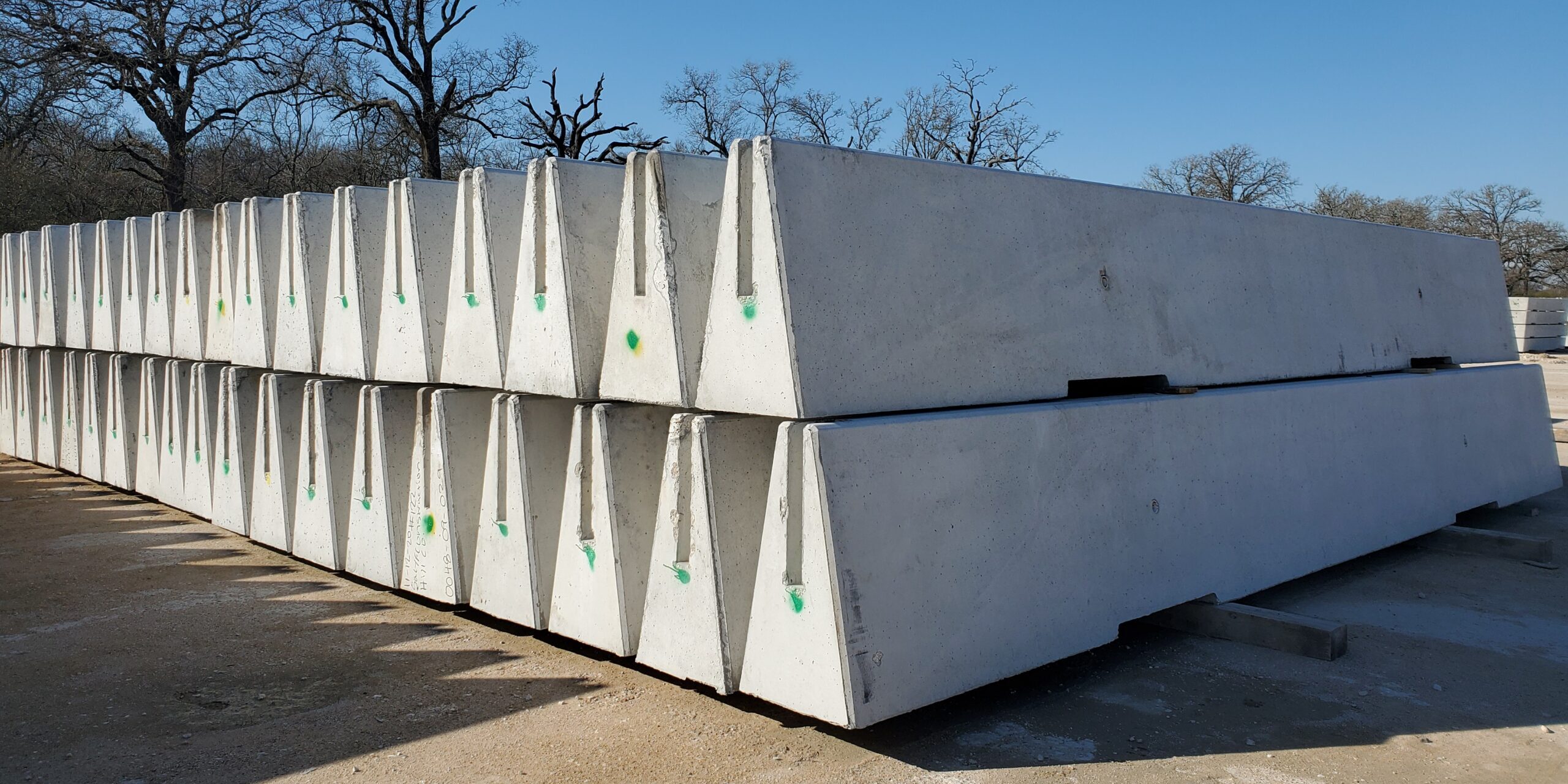

Summit Precast was awarded the traffic barrier scope, producing:
127,830 LF of 42″ single slope concrete barrier (SSCB)
126,360 LF of low-profile concrete traffic barrier (LP CTB)
That’s roughly 48 miles of concrete barrier, an essential component of safer traffic control and work-zone protection throughout the corridor improvements.
Barrier types noted in submission:
127,830 LF SSCB TY1 R-Connection
126,360 LF LPCTB TY1 & TY2 JJ-Hook Connection
Innovation highlight: JJ-Hook connectionFor this project, Summit Precast incorporated a new JJ-Hook connection into the low-profile traffic barrier. The connection improves barrier safety and increases on-site installation efficiency by reducing setting time.
Schedule + logistics (minimizing disruption)
Casting began: July 2025
Anticipated casting completion: September 2026
Shipping began: December 2025
Delivery cadence: primarily evening/night deliveries at ~3,000 LF per night to reduce impact on traffic flow
Project Team:
- Owner: TxDOT (Austin, TX)
- General Contractor: Fluor Heavy Civil, LLC
- Precast Manufacturer: Summit Precast Concrete (Montgomery, TX)
PCMA Associates
Afinitas U.S., Inc. • Alamo Cement • ALP Supply • Eco Material Technologies • Gosco Equipment Company • National Wire, LLC • Sika Corporation • Texas Lehigh Cement Co
FAQ
What is the TxDOT Brazos County Big 6 project?
A major SH 6 corridor improvement project in the Bryan/College Station region to improve safety, reduce congestion, and increase mobility for all users.
What precast products were used?
Precast traffic barriers: 42″ single slope concrete barriers and low-profile concrete traffic barriers totaling roughly 48 miles.
What is the JJ-Hook connection, and why does it matter?
A new connection is used on the low-profile barrier to enhance barrier safety and improve installation efficiency by reducing setting time.
How were deliveries managed to reduce traffic impacts?
Shipments began in December 2025 and primarily occurred in the evening/night at about 3,000 LF per night.
